Mangrove Planting in Bomu is HYPREP pilot planting project. Due to previous oil spill impacts and artisanal refining mangrove losses occurred. Some areas over time natural attenuation has occurred. Using remote sensing, HYPREP has delineated areas requiring direct Planting of mangroves, areas were divided into 9 LOTs and contracted out. Removal of Nipa palm, raking, tilling of sediment and Planting of mangrove seedlings (3 species) will be done by all contractors in their Grids.

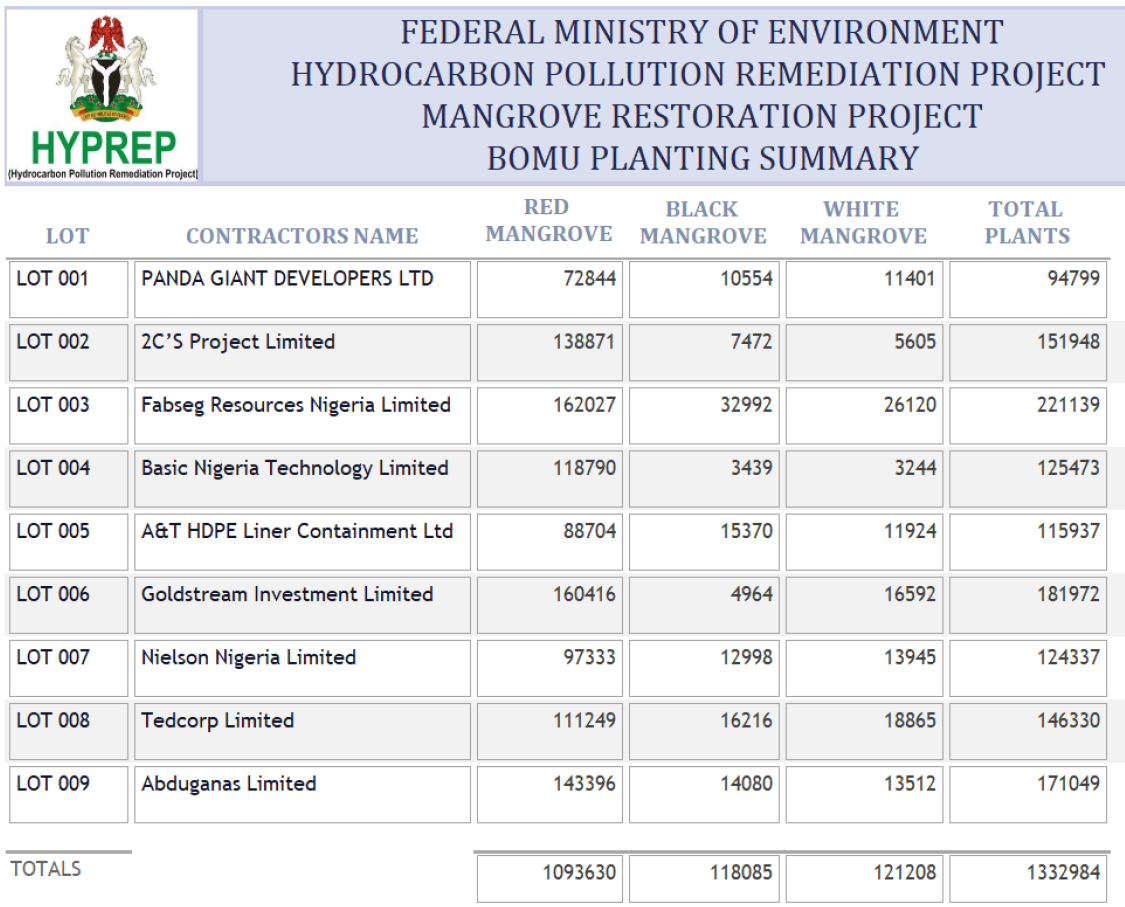

Summary of Mangrove Planting at Bomu Shoreline

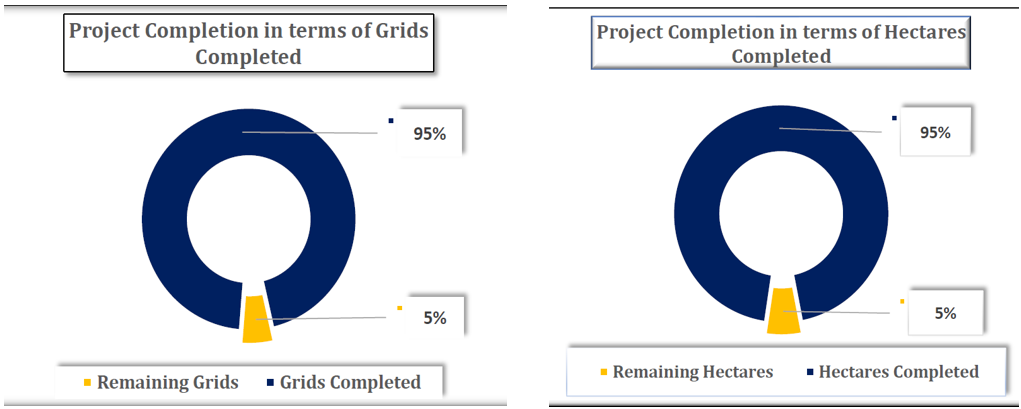

Project Completion Summary
MRP-001
LOT NUMBER: 001
LOCATION: Gokana LGA
CONTRACTOR: Panda Giant Developers Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 67.64
ESTIMATED PLANTATION: 169100
STATUS OF WORK ACTIVITIES: Base camp set up, planting of mangrove is in progress, a total of 94,799 mangrove has been planted so far.
MRP-002
LOT NUMBER: 002
LOCATION: Gokana LGA
CONTRACTOR: 2C’S Project Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 66.3
ESTIMATED PLANTATION: 165750
STATUS OF WORK ACTIVITIES: Base camp set up, planting of mangrove is in progress, a total of 97,805 mangrove has been planted so far.
MRP-003
LOT NUMBER: 003
LOCATION: Gokana LGA
CONTRACTOR: Fabseg Resources Nigeria Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 87.6
ESTIMATED PLANTATION: 219000
STATUS OF WORK ACTIVITIES: Workers mobilization for planting, planting of mangrove is in progress, a total of 149,212 mangrove has been planted so far.
“>
MRP-004
LOT NUMBER: 004
LOCATION: Gokana LGA
CONTRACTOR: Basic Nigeria Technology Ltd. .
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 79.6
ESTIMATED PLANTATION: 199000
STATUS OF WORK ACTIVITIES: Basecamp set up. planting of mangrove is in progress, a total of 122,819 mangrove has been planted so far.
MRP-005
LOT NUMBER: 005
LOCATION: Gokana LGA
CONTRACTOR: A&T HDPE Liner Containment Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 46.9
ESTIMATED PLANTATION: 117250
STATUS OF WORK ACTIVITIES: Workers mobilization for planting, planting of mangrove is in progress, a total of 104,072 mangrove has been planted so far.
MRP-006
LOT NUMBER: 006
LOCATION: Gokana LGA
CONTRACTOR: Goldstream Investment Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 56.2
ESTIMATED PLANTATION: 140500
STATUS OF WORK ACTIVITIES: Workers mobilization for planting, planting of mangrove is in progress, a total of 60,390 mangrove has been planted so far.
MRP-007
LOT NUMBER: 007
LOCATION: Gokana LGA
CONTRACTOR: Nielson Nigeria Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 45.2
ESTIMATED PLANTATION: 113000
STATUS OF WORK ACTIVITIES: Workers mobilization for planting, planting of mangrove is in progress, a total of 94,358 mangrove has been planted so far.
MRP-008
LOT NUMBER: 008
LOCATION: Gokana LGA
CONTRACTOR: Tedcorp Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 79.1
ESTIMATED PLANTATION: 197750
STATUS OF WORK ACTIVITIES: Workers mobilization for planting, planting of mangrove is in progress, a total of 88,362 mangrove has been planted so far.
MRP-009
LOT NUMBER: 009
LOCATION: Gokana LGA
CONTRACTOR: Abduganas Ltd.
SCOPE SUMMARY: Planting of mangrove and monitoring.
AREA OF LAND: 53.5
ESTIMATED PLANTATION: 133750
STATUS OF WORK ACTIVITIES: Workers mobilization for planting, planting of mangrove is in progress, a total of 113,488 mangrove has been planted so far.
